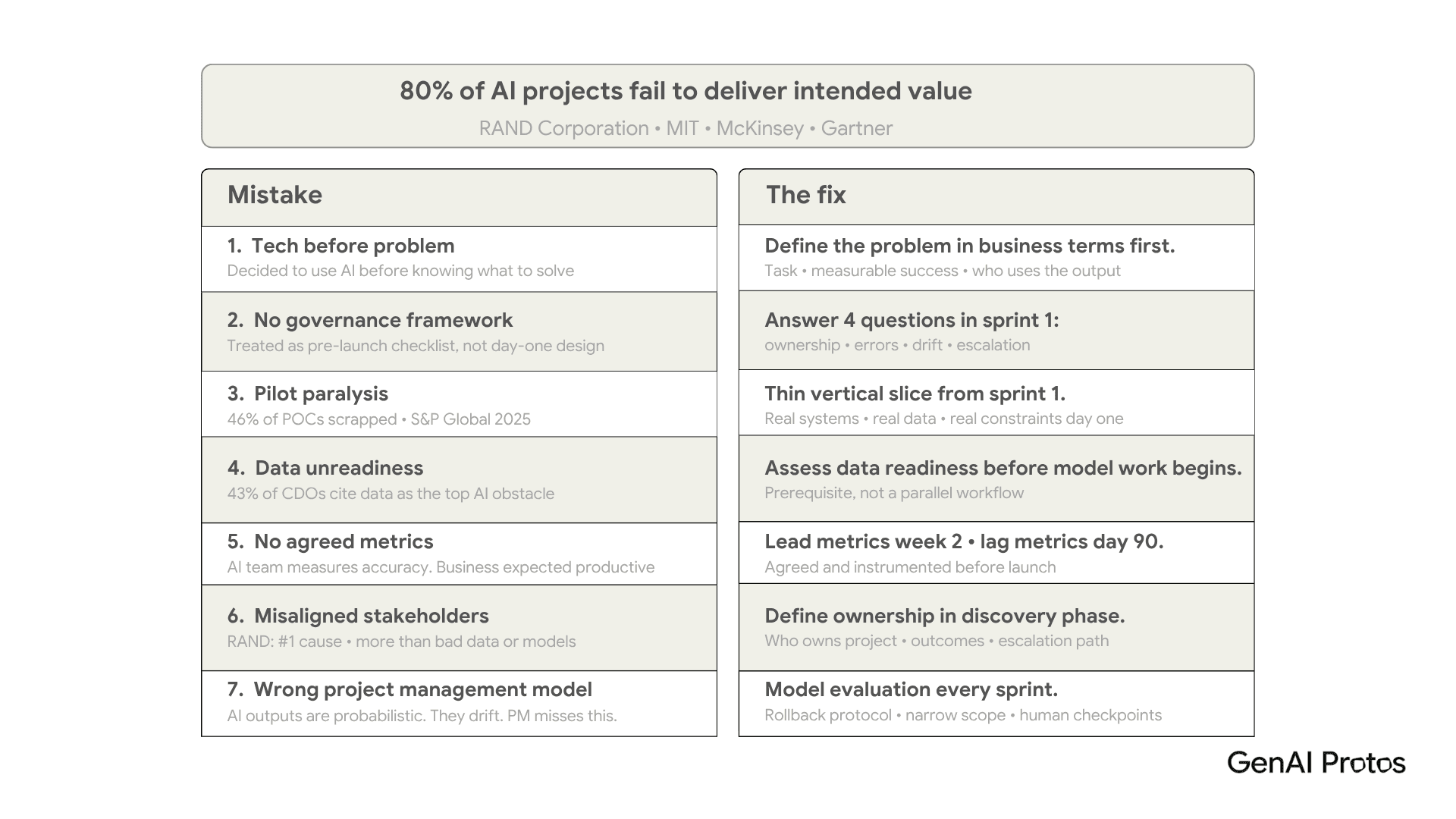

Over 80% of AI projects fail to deliver their intended business value. That figure comes from large-scale analysis of more than 65 enterprise programmes, with consistent findings across multiple independent research bodies. The failure rate for AI is roughly twice what you would expect from a conventional technology project.
What makes this pattern worth paying close attention to is that it is not a technology problem. The models work. The tooling has never been better. The failures are almost always organisational, architectural, or strategic and they follow the same script across industries and company sizes.
These are the seven mistakes that account for most of it.

Mistake 1 - starting with technology instead of the problem
The most expensive mistake on this list is deciding to use AI before knowing what problem it is solving. It sounds obvious, but it plays out repeatedly especially when leadership has approved a budget and teams feel pressure to show momentum quickly.
The result is usually a compelling demo six months in that nobody uses. The technology worked. The problem statement never existed.
The fix is disarmingly simple: write down the problem in business terms before opening a single vendor conversation. What specific task or outcome needs to improve? What does success look like as a measurable number? Who uses the output, and where does it fit in their actual workflow? Answer those three questions first, then decide what technology if any helps.

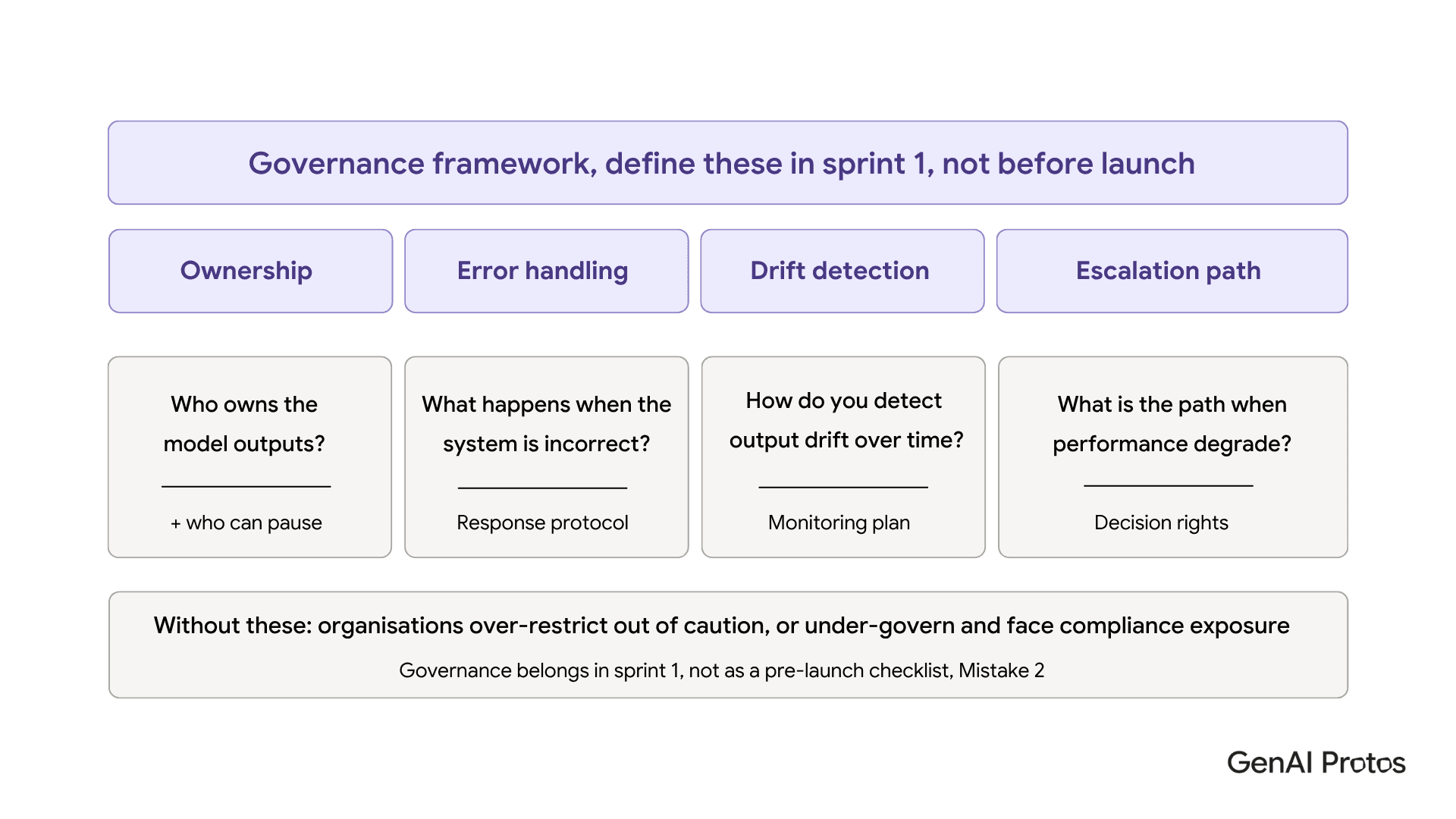

Mistake 2 - no AI project governance framework from day one
Governance is the most under-resourced element of enterprise AI delivery. Teams budget for model development and infrastructure, then treat governance as a checklist item to complete before launch. By that point, designing it properly is no longer realistic.
An AI project governance framework has to answer four specific questions before the system goes live: Who owns the model outputs? What happens when the system produces an incorrect result? How do you detect drift in outputs over time? What is the escalation path when performance degrades?
Without clear answers to these, organisations end up in one of two places either over-restricting the system out of caution, which kills adoption, or under-governing it and facing compliance exposure later. Neither is a good outcome for a project that was meant to generate value.

Struggling to structure your AI delivery process?
GenAI Protos offers structured AI project scoping helping you define governance, architecture, and delivery milestones before code is written.
Explore On-Demand AI Labs → genaiprotos.com/our-services/on-demand-ai-labs-and-experimentation
Mistake 3 pilot paralysis: POCs that never reach production
According to a 2025 industry survey, 46% of AI proofs-of-concept are scrapped before they ever reach production. The reason is almost always the same: the prototype was built in a clean environment, using curated data, disconnected from the authentication systems, legacy integrations, and real data constraints that a production system actually has to handle.
The demo works. Production does not. The gap between the two becomes the project's undoing.
The fix is to build for production from the very first deliverable. At GenAI Protos we use a thin vertical slice approach a narrow but complete path through the real system, including real authentication, real data sources, and real integrations, delivered in the first sprint. Production constraints surface in week two, not month six. That difference in timing has a meaningful impact on cost and overall delivery risk.
Mistake 4 - underestimating data readiness
43% of data leaders identify data quality and readiness as the top obstacle to AI success. That figure has been consistent across surveys for several years, yet it remains systematically underestimated when projects are scoped and planned.
Most enterprises have plenty of data. The problem is that it is fragmented across systems, inconsistently governed, formatted for reporting rather than AI consumption, and never designed with machine learning in mind. Vendor demos run on clean, curated datasets. Production systems run on years of accumulated operational data which looks nothing like that.
Data readiness is not something you address in parallel with model development. It is a prerequisite. Starting model work without a proper data readiness assessment is building on unstable ground, and the instability tends to become visible at the worst possible moment.
Mistake 5 - no agreed metrics before launch
Teams launch AI systems without first agreeing on what success looks like in measurable terms. The consequence is predictable: the AI team measures accuracy and precision, declares the system working, and the business unit which expected to save 30 hours per week calls it a failure. Both are right by their own definition, and both lose.

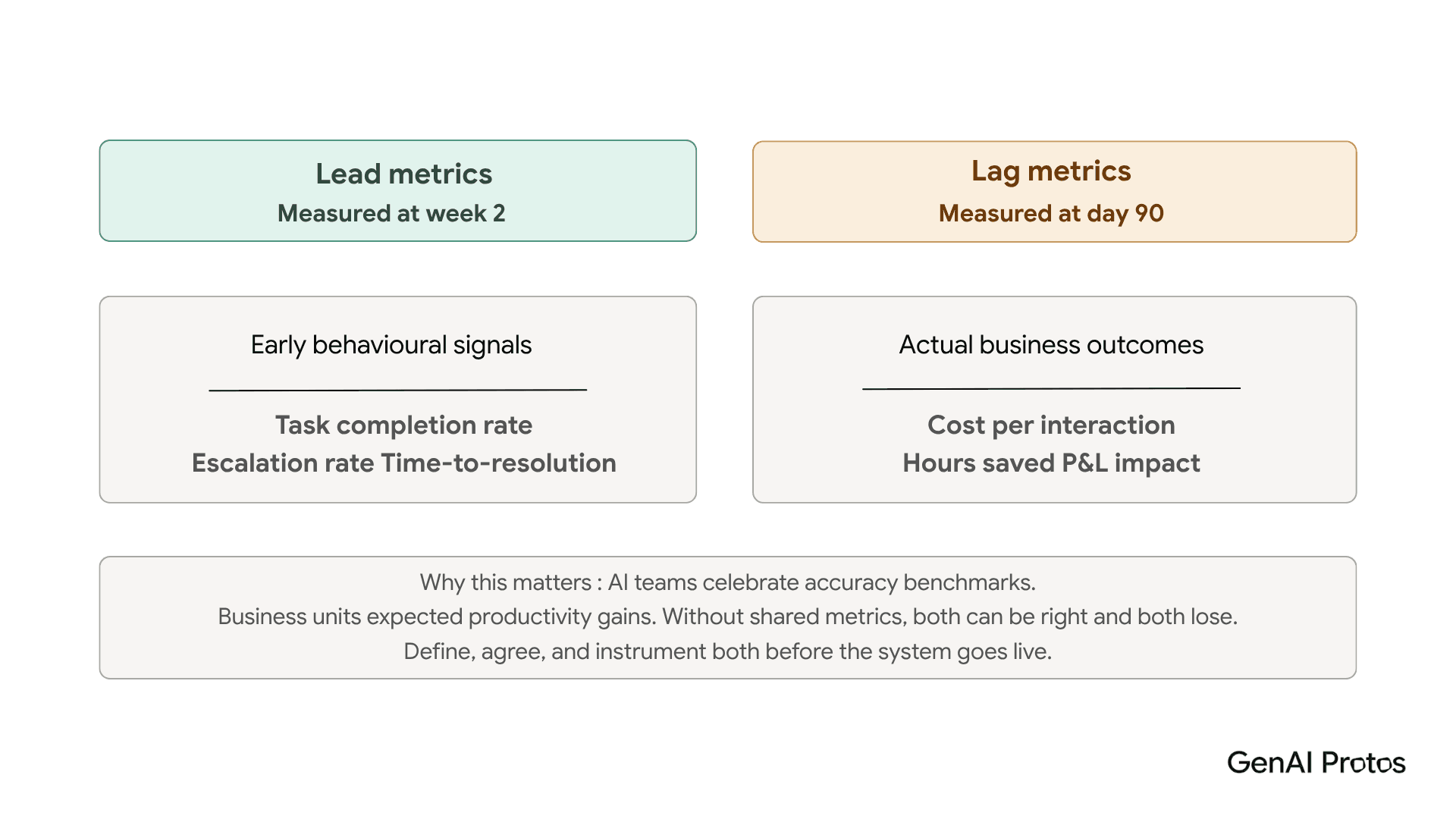

The framework that works uses two measurement levels. Lead metrics capture early behavioural signals within the first two weeks: task completion rate, escalation rate, time-to-resolution. These tell you quickly whether the system is functioning in a live environment. Lag metrics measure actual business outcomes at 90 days: cost per interaction, hours saved, P&L impact. These tell you whether the project delivered what it was supposed to deliver.
Both need to be defined, agreed across stakeholders, and instrumented before the system goes live not negotiated retrospectively when someone raises a concern.

Want a structured approach to AI measurement and governance?
GenAI Protos includes measurement frameworks in every delivery engagement.
Explore Full-Stack AI Engineering → genaiprotos.com/our-services/full-stack-ai-engineering
Mistake 6 - misaligned stakeholders and missing executive sponsorship
Repeated research identifies misaligned incentives as the most common cause of AI project failure more common than bad data, bad models, or bad tooling. The pattern is consistent: the AI team is measured on model performance, the business unit is measured on operational outcomes, and the moment the project hits its first real challenge, those two incentives pull in opposite directions.
Executive sponsorship alone does not fix this. What fixes it is establishing clear ownership in the discovery phase who owns the project, who owns the business outcomes, how disagreements get resolved, and what the escalation path looks like when something goes wrong. These conversations feel administrative. They are actually load-bearing.
Mistake 7 - managing GenAI projects like traditional software
GenAI project management is not software project management with a different name. The underlying characteristics are meaningfully different: AI outputs are probabilistic rather than deterministic, models drift over time in ways that are difficult to detect without active monitoring, and a system that performed well in testing can degrade silently in production.
Effective AI delivery requires sprint rhythms that include model evaluation reviews alongside feature reviews. It requires rollback protocols as a standard part of the deployment plan not an emergency response written after something goes wrong. It requires human-in-the-loop checkpoints built into the workflow design, not added after a failure event.
Scope discipline also matters more than in conventional software delivery. The instinct to broaden the problem as confidence grows is one of the most reliable paths to failure. Keep scope narrow and deep in the early stages solve one problem completely before expanding to the next.
What successful AI project delivery actually looks like
Organisations that consistently generate measurable value from AI share a recognisable pattern. They start with a clearly articulated problem, not a technology. They assess data readiness before model development begins. They build governance into sprint one rather than the launch checklist. They agree on metrics before anyone writes a model.
And they ship something narrow and complete in weeks not something broad and impressive in months that never makes it to production.
- Business problem and success criteria defined before architecture decisions
- Data readiness assessed and gaps addressed before model development begins
- AI project governance framework established in sprint 1
- Lead and lag metrics defined, agreed, and instrumented before launch
- Production path designed from day one no separate productionisation phase
- Rollback protocol documented and tested before go-live
None of these steps are complicated. They are just consistently skipped usually because the pressure to show progress makes them feel like obstacles. They are not obstacles. They are precisely the reason some AI projects deliver and others do not.
